Fintech Modernization: From Green Status to Real Delivery Visibility

Executive Summary

A large U.S.-based FinTech enterprise was executing a critical modernization initiative—migrating a highly customized on-prem platform to the cloud.

Despite being a top organizational priority, leadership struggled to understand true progress. Status reports consistently showed “green,” while signals from teams indicated increasing risk.

Through a structured execution clarity assessment and a 90-day Predictable Delivery Program, the organization:

  • Eliminated false confidence created by misleading status reporting

  • Improved delivery predictability by 37%

  • Achieved 90% portfolio data health and 100% iteration data health

  • Increased execution clarity by over 50% across key metrics

  • Stabilized delivery throughput with less than 10% variance

  • Significantly reduced blocked and duplicate work

  • Delivered the program only one week behind schedule, versus an expected delay of several months

The Challenge

The organization was executing a complex modernization program involving:

  • Migration from on-prem to cloud

  • Heavy customization of a vendor platform

  • Ongoing vendor-led upgrades requiring compatibility

  • Multiple internal teams and six dependent delivery teams

Key challenges included:

  • False visibility: Status reports showed “green,” but leadership received conflicting signals from teams

  • Lack of ownership clarity: No clear accountability for prioritization or delivery coordination

  • Vendor dependency complexity: Internal and vendor teams worked simultaneously without clear coordination

  • No realistic roadmap: Delivery plans did not reflect actual team capacity or scope

  • Siloed execution: Analysts and developers worked independently with minimal collaboration

  • Uncontrolled backlog growth: Work entered the system from multiple sources without refinement or prioritization

  • Duplication of effort: Teams unknowingly worked on overlapping items

The result was a high-risk program with limited transparency, increasing delays, and declining leadership confidence.

What Was Actually Broken

The issue was not capability or effort—it was the execution system.

The assessment revealed:

  • Lack of clear ownership for prioritization and execution

  • No shared understanding of what “ready” or “done” meant

  • Weak collaboration between business, delivery teams, and vendor

  • Absence of a structured delivery system

  • No visibility into dependencies and handoffs

  • Fragmented communication channels

  • Misleading status reporting that masked real risks

 Approach

Execution Clarity Assessment

A structured assessment was conducted across delivery teams and leadership.

This focused on understanding how work was actually flowing across:

  • Internal teams

  • Vendor dependencies

  • Backlog management

  • Delivery execution

The findings exposed a critical gap between reported status and actual progress.

Predictable Delivery Program (90 + 30 Days)

A structured 90-day program was implemented, followed by a 30-day sustainment phase.

Key interventions included:

Role Clarity & Ownership

  • Established clear ownership for prioritization through a Product Owner role

  • Introduced quarterly OKRs to align work with business outcomes

  • Rebuilt the portfolio backlog to reflect only outcome-driven work

Work Structure & Definition Standards

  • Established clear Definition of Ready (DoR) and Definition of Done (DoD)

  • Defined a structured discovery value stream aligned to readiness criteria

  • Ensured all work met clear progression standards before entering delivery

Team Collaboration & Delivery System

  • Unified analysts, developers, and product roles into a single collaborative workflow

  • Introduced structured ceremonies for:

    • Discovery

    • Planning

    • Progress tracking

  • Eliminated redundant and isolated meetings

Vendor Alignment & Dependency Management

  • Established clear communication channels with the external vendor

  • Made vendor-related work visible within the delivery system

  • Defined explicit handoff and review stages

  • Introduced a team-of-teams coordination forum to manage dependencies across six delivery teams

Delivery Visibility & Roadmapping

  • Created a delivery roadmap aligned to actual team capacity

  • Provided leadership with a realistic view of scope, progress, and risks

  • Enabled proactive decision-making

Measurement & Transparency

  • Established clear metrics for:

    • Delivery predictability

    • Data health

    • Throughput

  • Replaced subjective RAG status with actual delivery data

  • Enabled transparent reporting across teams and leadership

What Changed

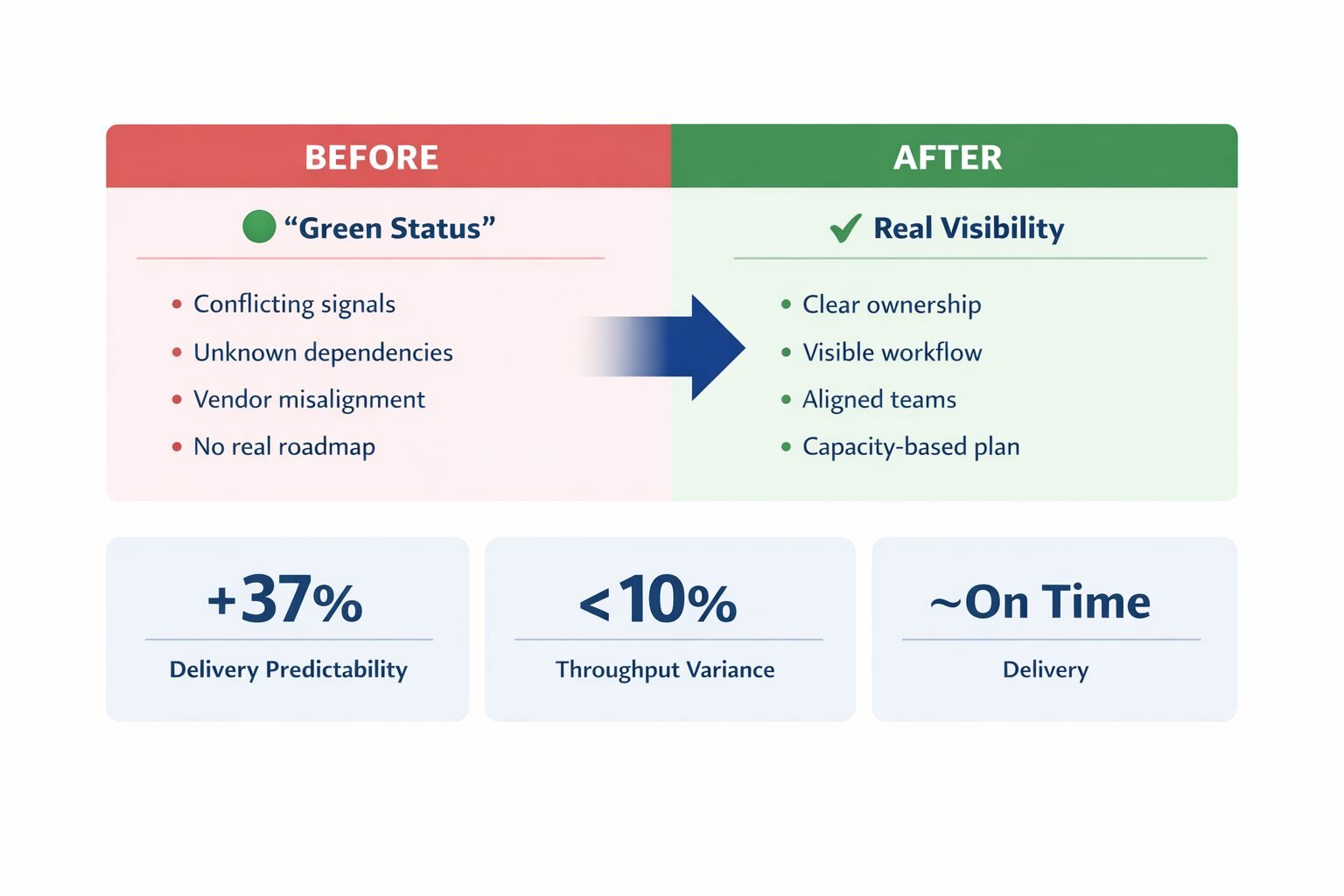

From ‘Green Status’ → Real Visibility

Leadership moved from misleading status reporting to a clear, data-driven understanding of progress.

This enabled:

  • Accurate visibility into risks and dependencies

  • Early identification of issues

  • Informed decision-making

From Siloed Execution → Aligned Delivery

Teams transitioned from working independently to collaborating as a unified delivery system.

This resulted in:

  • Elimination of duplicate work

  • Improved coordination across roles

  • Faster and more consistent delivery

From Vendor Friction → Coordinated Execution

Vendor interactions became structured and transparent.

This enabled:

  • Clear ownership of work across teams

  • Reduced delays in handoffs

  • Improved collaboration with the vendor

From Reactive Management → Structured Execution

The program shifted from firefighting to a controlled, predictable delivery model.

This resulted in:

  • Reduced unproductive meetings

  • Clear prioritization aligned to outcomes

  • Improved execution discipline

Outcomes

Delivery Predictability

  • Improved by 37%

  • Enabled reliable planning and expectation setting

Execution Clarity & Data Health

  • Portfolio data health reached 90%

  • Iteration data health reached 100%

  • Improved clarity across key execution metrics by 50%+

Throughput Stability

  • Delivery throughput stabilized with <10% variance

  • Enabled consistent delivery pacing

Dependency & Blocker Reduction

  • Significant reduction in blocked work items

  • Improved visibility and management of dependencies

Leadership Confidence

  • Leadership gained clear, real-time visibility into execution

  • Confidence in reporting and delivery significantly improved

Program Outcome

  • Program delivered only one week behind schedule

  • Compared to an expected delay of several months or longer

 Key Takeaways

  • “Green status” often hides execution risk

  • Visibility is a system problem—not a reporting problem

  • Role clarity and structured workflows drive alignment

  • Vendor coordination must be embedded into the delivery system

  • Data-driven visibility enables better leadership decisions
